|
        The Urban Housing Policy
        Debate
 Housing Programmes Housing for
        All is a priority commitment for the Indian Government. The vision is
        that every family will have a pucca (permanent) house with water
        connection, toilet facilities, 24Χ7 electricity supply and access. The
        programme proposes to build 20 million affordable houses for the
        economically weaker section in metros, small towns and all urban areas
        of India by 2022. The budget has allocated Rs 22,407 crore for the
        housing and urban development sector for this fiscal year. Housing schemes have been planned and implemented
        before, without reaching the goal of eliminating homelessness. The
        Jawaharlal Nehru National Urban Renewal Mission (JNNURM), launched in
        2005, was the first and biggest effort in the post-independence history
        of India to comprehensively address urban development. The scheme ran
        from 2005 to 2014, after being extended by two years for the completion
        of delayed projects.  In 2012, the Ministry of Housing and Urban Poverty
        Alleviation (HUPA) pegged the housing shortage at 18.78 million units,
        with 96% of this demand in the affordable housing space. With the gap
        expected to grow to 38 million units by 2030 (MGI, 2010), the new target
        still falls short of eliminating homelessness. Thus it is important to
        understand the causes behind this implementation gap.  Implementation Gaps While policies do exist, there have been multiple
        gaps in the
        translation of these policies into implementation that reduce the

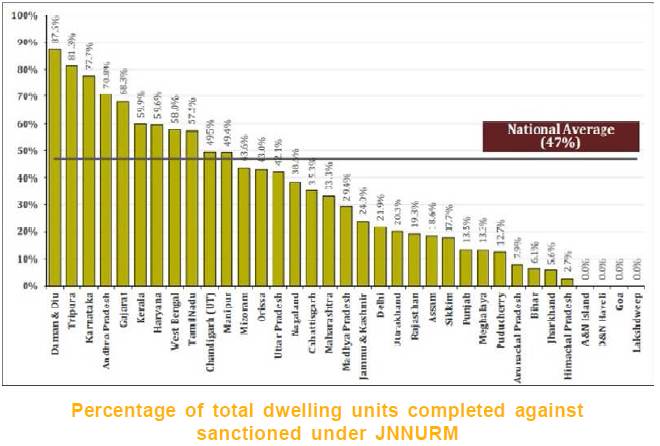

        impact. A progress study by HUPA in September 2013, showed that only 47%
        of the dwelling units sanctioned under JNNURM had been completed. In
        Punjab, 87% of the units sanctioned were either not started (48%) or not
        completed (39%). The discrepancy between disbursement of Central
        Assistance (ACA) and completion of dwelling units on the other is
        particularly striking in some states and highlights implementation
        difficulties. In Sikkim, 94% of ACA had been released, but only 17.7%
        sanctioned dwelling units had been built. In Rajasthan, 73.3% ACA had
        been disbursed, but only 19.3% of units had been completed. A year
        later, only about 59% of the dwelling units sanctioned across the
        country had been completed but 87.6% of committed funds were released.
        Additionally only 43% units were actually occupied.  Thus the scheme was unable to meet its target of
        providing shelter both due to units not being constructed as well as
        lack of occupation in the completed units. Low retention and acceptance
        of social housing projects is not just limited to JNNURM. Similar
        experiences have been seen in many other state and centrally sponsored
        housing schemes. A study to gain insights and a deeper understanding of
        the situation on the ground reflected some causes of these lack lustre
        statistics. They are illustrated below.   Land
        Constraints The responsibility for provision of land - a prime
        resource for housing lies with the government. Consultations with key
        stakeholders across various states in India revealed that a major
        bottleneck for affordable housing projects is adequate availability of
        land. Most medium to large cities do not have enough land near the city
        centre, thus slums and new housing projects (especially affordable) are
        relocated on the outskirts of the city, often beyond the municipal
        boundaries. This relocation adversely affects the displaced populace by
        removing them from their livelihood, often distancing them from basic
        amenities like markets, hospitals and schools. Travel routes are also
        not well developed especially in the smaller towns to ease the
        transition. This relocation is often quoted as the single most important
        reason for attrition and desertion of these allotted houses.  Financial
        Mismanagement The HUPA JNNURM progress study found instances of
        fund diversion from housing projects towards other initiatives such as
        toilet construction (Jammu & Kashmir), DPR preparation (Jharkhand),
        agency charges (Haryana) etc. This has obvious adverse effects on
        progress.  Another area of concern is the cost escalation due to
        inflation between the project planning and construction stages. The
        centres share is fixed. The urban local body or implementation agency
        often cannot bear this expense and they end up passing it on to the
        consumer. Further delayed release of funds as is often the case in
        government projects, exacerbates the situation. Projects often get
        stalled due to this reason. This was observed in self-financing schemes
        such as the Rajiv Swah Gruh Scheme in Andhra Pradesh where the
        implementation agency was unable to bear the costs and the scheme shut
        down.  Quality of
        Construction Construction of housing especially in the numbers
        required to meet the demand is very resource intensive. Resource
        efficiency in materials and technologies can go a long way in reducing
        this pressure on resources and the environment as well in reducing the
        cost of construction. However, they are often not mainstreamed in
        construction and the government schedule of rates that govern material
        use. Additionally, limited technical capacities of implementation
        agencies on these alternative materials and technologies retards the use
        of these options.  While this is true for all housing and construction,
        the affordable housing sector faces a serious acceptance issue from
        users due to the common perception of these alternates. The Kerala
        experience shows that use of these technologies in institutional and
        high income construction creates a demonstration effect increasing
        acceptance within the LIG (Low Income Group) and EWS (Economically
        Weaker Section) sectors.  Another concern among home owners is the small size
        of houses allocated. EWS houses are in the range of 21-27 sqm carpet
        area. This barely accommodates a bedroom, a common room and a tiny
        kitchen. The lack of privacy and overcrowding of 2 to 3 generations of
        the family in the same house is a major problem. Moreover, a HUPA study
        of a project in Tirupati, Andhra Pradesh found that while approved
        carpet area of each dwelling unit was to be 25.39 sqm, in actual
        construction the carpet area was 14.74 sqm and built up area was 20.96
        sqm.   Identification and Selection of Beneficiaries Beneficiary selection and allotment is one of the
        most politically coloured processes in these schemes. Politicians use
        housing schemes as a means to confer favours upon voters, thus political
        tussles often result in unnecessary delays in allotment. The CAG report
        by the HUPA highlighted this. A Development Alternatives (DA) study in
        Kerala and Madhya Pradesh in 2014 had similar observations. This
        political interference also colours repayment rates and schedules among
        the allocated units. Consultations with stakeholders in Andhra Pradesh
        estimated the non-repayment rate to be as high as 90% in certain
        pockets.  Also surveys conducted for identification often have
        unclear eligibility guidelines. This process does not take into account
        adult children marrying and starting their own families in the duration
        of the construction and definitely does not account for future
        population growth. The DA study clearly brought this out as a major
        source of dissatisfaction among the beneficiaries.   Ownership and
        Tenure Successful community participation and engagement
        throughout the process of planning and construction enhances ownership
        as the Development Alternatives report highlighted from the Sangli
        experience. Moving from a predominantly horizontal ground based housing
        plan to an apartment as is the case with most schemes requires some
        time. Community based cooperative process can help ease the transition.
        Also valuing the asset provided helps build ownership. While a feeling of ownership can be created among
        beneficiaries through various approaches, tenure ship often creates
        security concerns. Studies conducted by Development Alternatives showed
        that most schemes transfer the house deed to the beneficiary after all
        instalments have been paid, with a caveat that prevents them from
        selling the asset for a period of 7-15 years. This in practicality is
        not enforced, thus people buy and sell (speculation) or sell and return
        back to slums (convenience). Also as the land belongs to the government,
        sometimes there are not clear documents that highlight the entitlement
        of the occupants, keeping alive the fear of eviction.   Supporting
        Infrastructure and Living Conditions Not Suitable Supporting infrastructure plays an important role in
        determining retention. HUPA studies show that the reasons vary from
        proximity to garbage dumps to narrow approach roads that restrict
        movement of people and emergency services like ambulance, police van or
        a fire engine. Thus the social infrastructure and land development have
        to be undertaken simultaneously with the housing programmes to ensure
        that basic provisions and urban facilities are provided to the
        occupants. Thus some of the key aspects that policy makers need
        to consider while drafting and implementing housing and habitat policies
        are as follows:  Appropriate
        beneficiary selection with timely allocation for occupation  Use of resource
        efficient materials and technologies to maintain quality  Appropriate size
        of houses that meet basic needs and privacy concerns  Social
        infrastructure to be developed simultaneously with housing  Appropriate
        financial tools and mechanisms in place between all stakeholders  Exploring
        alternative innovative models like rental models
