The
month was October and the year 1999. Nature's fury was unleashed on
the eastern coast of Orissa in an unprecedented manner and the
resulting loss of life and property was beyond human comprehension.
In March, representatives of CARE-India, approached Development
Alternatives to help propose a rehabilitation and reconstruction
project in Orissa. Several brainstorming sessions resulted in the
formulation of a project called "Ashraya", which was seen
as an extension of their ongoing efforts to disseminate Cost
Effective and Environmental Friendly (CEEF) building materials on a
large scale as part of the Building Materials Project supported by
the Swiss Agency for Development and Cooperation (SDC).
Here
was a situation where there was a need (Demand) for affordable and
appropriate building materials ,mechanisms and processes to create
the delivery (Supply) chain and ensure its sustainability to fulfil
long term needs. Supply was to be addressed through technology
demonstration and transfer, whereas Demand was to be addressed
through demonstration and awareness creation, with the crucial links
in the chain provided by Capacity Building measures. Targeted

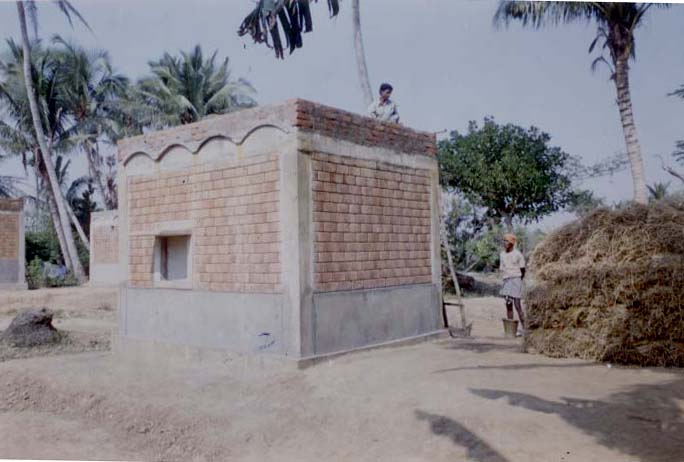

families( about 1400 ) would be provided with Core houses, which
would not only serve the immediate need of secure shelter but also
serve to demonstrate the effectiveness and appropriateness of the
technologies and capacity of the supply chain to deliver.
Preliminary
need assessment studies revealed an existing supply chain comprising
labourers, masons, petty contractors, dealers, vendors, distributors
etc who were concentrated around the district or block headquarters
and other major villages. Virtually non-existent connectivity in
terms of roads or waterways made access to materials and skills
difficult and a very expensive proposition. The market could not
fulfil the demands of building materials posed by the mammoth
reconstruction measures. As a result, prices went spiralling up,
quality took a plunge and the chasm between demand and supply
continued to become deeper and wider. At the same time, people had
realized the vulnerability of their homes and observed the
resistance of’ concrete houses. Misinformation about the
irrational design of concrete houses prevailed among a completely
unaware population, as petty contractors and even semi-skilled
labourers who became masons overnight were being sought after.
The
"Ashraya" project sought to address the key issues in the
supply chain, namely, availability, access and quality by setting up

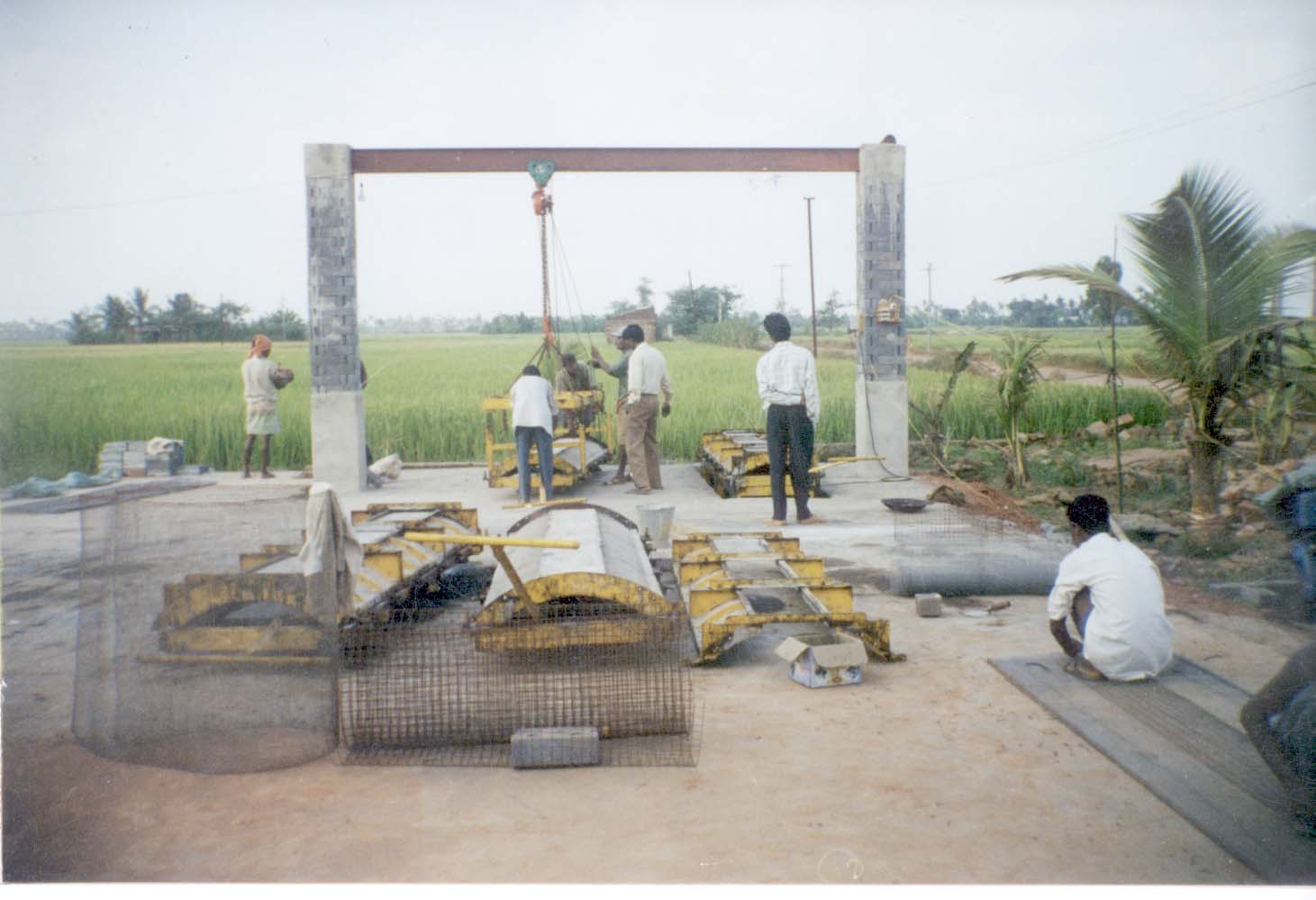

Building Materials and Services Banks (BMSBs) close to the targeted
population. These are sourcing and production centres from where
building materials and elements flow to reach every village and
hamlet of the district. These are run by local organisations
employing local skilled and unskilled labour and are open to the
public so that they are always aware of the "why" and the
"How" of production as well as construction.
The
project initiated to addressing these aspects with a major capacity
building initiative. The targeted beneficiary families organised

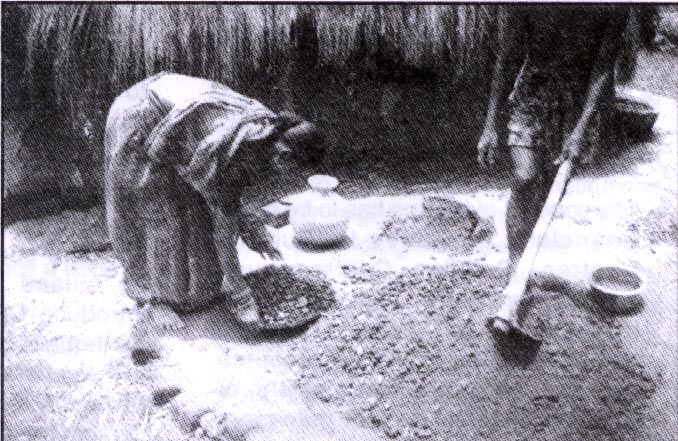

into Village Construction Teams are taught all about the basics of
construction technology including materials and building elements.
They are taught why more cement is not necessarily more strength,
they are taught how to measure quantities, supervise construction
and above all how to recognize quality. They are being exposed to
the different alternatives available for every component of their
house so that they have a greater understanding and hold over the
construction of their houses. It was envisaged that a Mobile
Building Center would be put in place to provide for greater
awareness amongst the larger population, but this did not take off
due to various reasons.
In
the context of the project ,having set up the BMSBs and providing
information to families was never going to be enough, the crucial
link connecting the two had to be developed, built and reinforced.
This crucial link " Delivery" and the way it is affected
is what sets the project apart.
The
delivery vehicles are local NGOs with established bases and track
record of having worked with the people in the area and who will be
present after DA withdraws from the field. These NGOs have been
identified and strengthened to perform the various activities
required in the execution of a large housing project. Some of the
major partners run and own the BMSBs while others source materials,
elements and construction skills. Capacity building of these NGO’s
at various levels in management, finance, production, construction,
logistics, quality control, procurement, monitoring and supervision
has taken place.
Today
about 750 people are directly associated with the project everyday
and about 500 houses have already been built and handed over. Large
numbers of manpower at various levels have been trained: about 500
masons in construction technologies, about 100 skilled technicians
in production, about 250 odd in unskilled production related jobs,
100 odd people in supervision and monitoring, about 50 people in
management and finance, about 25 engineers and other graduates in
program management and about 600 families have had their capacities
built to make better and informed choices.
A
Technology Workshop
Recently,
DA has launched an initiative to strengthen two building centres
being run by the Arupanand Mission Research Foundation in Kujang and
Ersama blocks of Jagatsingpur district in Orissa. This GTZ (Deutsche
Gesellschaft fur Technische Zusammenarbeit) supported project aims
to make the centres more responsive to the needs of poor home
builders and is targeted at training rural youth, including women,
to become role players in awareness generation and delivery.
A two
day workshop titled "Products, Technologies and Services
Selection workshop" was organised by the Arupa Mission’s
Research Foundation( AMRF) on September 3-4 at Bhubaneswar. The
workshop was facilitated by Development Alternatives (DA) who are
the technical backstoppers to the project and was sponsored by GTZ..
The Chief Guest at the workshop was Shri. Biswabhusan Harichandan,
Hon’ble Minister Revenue & law, Govt of Orissa. The workshop
was very well attended, with dignitaries from HUDCO, RRL-Bhubaneswar,
OSDMA, UN House, OUAT and representatives from different NGOs and
other building centers. A few Engineers ,Architects practising in
Bhubaneswar and some Management students also participated in the
workshop. The DA Orissa team conducted the workshop and the whole
exercise was very well received by the participants.
The
success of these initiatives will be measured by whether the
sustainability or rather the continuity of the process has been
achieved as a result of capacity building. It is therefore crucial
that towards the end of the project, we make an appraisal of the
capacity building initiatives, adopt corrective measures if any,
reinforce existing initiatives and plan for long term ones such that
the process becomes sustainable. The BMSB’s ,it is expected, will
turn into commercially viable enterprises serving the long term
needs of the population and it will be most appropriate if
Development Alternatives continues to support these BMSB’s and
others over a longer period. q
The
author is project co-ordinator of
"Ashray" Programme in Orissa.
|
